Stop the MAGA-owned pipeline in British Columbia

Backed by MAGA billionaires

PRGT is backed by trillion-dollar Wall Street companies. The investors behind PRGT include billionaires with close, personal ties to Trump.

Many of PRGT’s US investors are the very firms that took over the US Gulf Coast with LNG export projects, which rapidly raised utility bills and poisoned entire communities. Allowing PRGT to go ahead would be equivalent to opening our front door and welcoming US exploitation. We should be building Canadian-owned sustainable energy alternatives instead of lining the pockets of MAGA billionaires.

Sign saying "road close to LNG transport" and protest with "Stop PRGT" sign.

Higher Bills

Just one large LNG terminal would use the entire power output of the Site C dam. That’s enough electricity to power 450,000 homes per year in B.C. Anyone who pays a B.C. Hydro bill is currently paying for the new dam – all so oil and gas companies can enjoy cheap electricity. LNG exports mean higher bills for natural gas too. That’s because B.C. households will be paying the same high prices as Japan or Korea, once we join the international market.

Hydro tower and stovetop.

old permits

The B.C. government approved this TC Energy pipeline more than 10 years ago, but was immediately blockaded by Gitxsan leaders and land defenders. Since then, the project has changed many times. The project’s owners no longer want the pipeline to go to Prince Rupert. B.C.’s laws have changed. And the climate has changed too.

The project’s Environmental Assessment Certificate expired on November 25, 2024. The B.C. government must now decide whether to revive PRGT’s 10 year-old certificate, or let the project expire. Indigenous leaders and allied organizations along the pipeline route are calling on the B.C. government to reject PRGT – or at least put this pipeline through a modern Environmental Assessment.

Food, Family, Fresh water: All at Risk

If the pipeline were allowed to proceed, it would cross hundreds of fish-bearing streams and rivers. Fed by glaciers, the Nass and Skeena rivers are a fortress of food security and clean water for Nisga’a, Gitanyow and Gitxsan people. These rivers are currently a major economic driver for the region but must remain intact to continue supporting the local economy. Communities all over B.C. are relying on Nass and Skeena salmon runs due to losing local salmon close to home.

One of the healthiest river systems in the world, the Nass still has five species of salmon, plus steelhead ad oolichan.

Naas river and close up of salmon under water.
People holding sign that reads "No pipelines! Stop PRGT." PRGT campsite.

No Consent

The pipeline would cross more than 100km of Indigenous territories where title holders have denied consent for PRGT. Indigenous leaders and nations must be respected when they choose to say no to new proposed projects on their territories for there to be any meaning to claims about reconciliation and free, prior, informed consent (FPIC) by different levels of government. The whole world watched as the Coastal GasLink pipeline was violently forced through Wet’suwet’en territory without consent of hereditary leaders and with RCMP military assault tactics as the modern face of colonial violence – the opposite of reconciliation.

Stand up for British Columbians — We don’t want a MAGA-pipeline in BC

Opposition to PRGT is Wide and Deep

Indigenous land defenders and non-Indigenous allies are working together in the region and across BC to send a powerful message : NO PRGT. This website is supported by the Skeena Watershed Conservation Coalition, Nass Valley Tribal Alliance Society, Kispiox Valley Community Centre Association, Gitxsan Laxyip Youth and Dogwood BC.

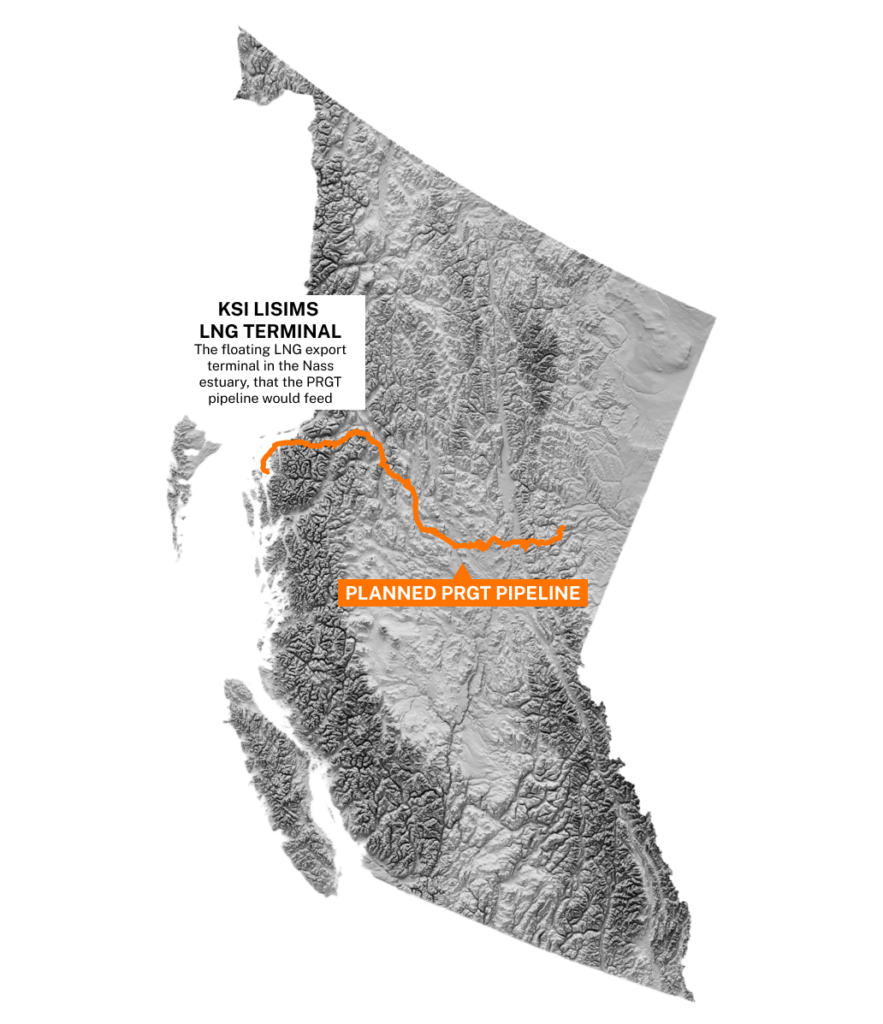

Map of proposed PRGT pipeline in British Columbia.
  • PRGT on Social media

    PRGT on Social media

    @dogwoodbc As #PRGT construction ramps up so that pipeline owners can prove a “substantial start” before their outdated environmental certificate expires in November, opposition amongst northern B.C. Indigenous groups is intensifying, with youth and chiefs from the Gitxsan, Ts’msyen, Gitanyow, and Nisga’a nations vowing legal and direct action against the B.C. government and other pipeline backers. @mikegraeme …

    Continue reading…

  • Key Articles

    Key Articles

    Since August, frontline communities have launched two legal actions against substantial start construction and the Ksi Lisims terminal – the LNG project the PRGT pipeline would feed.

    Continue reading…

  • Legal actions

    Legal actions

    Days before PRGT construction was set to start, Gitanyow Hereditary Chiefs burned their pipeline agreements, closed their territories to all LNG traffic related to the new pipeline and set up a checkpoint on a remote road about 170 km north of Terrace, B.C. The checkpoint, established on August 21, 2024, forced LNG traffic to turn…

    Continue reading…

Newly-appointed Environment Minister, Tamara Davidson, must decide whether the PRGT pipeline can move forward or if it needs to begin all over again in a new environmental assessment process. Indigenous leaders and communities along the pipeline route are calling on Minister Davidson to allow the ten-year old certificate to expire, and order a modern environmental assessment that respects Indigenous rights.

2014

PRGT receives its Environmental Assessment permit and is immediately blockaded by a Gitxsan house group, Luutkudziiwis, at Madii Lii.

2015

Ts’msyen land defenders, supported by allies across the Skeena watershed, reoccupy Lelu Island and block construction of the project terminal.

2017

Petronas officially cancels its LNG terminal, leaving PRGT without a destination. The pipeline is left in limbo for seven years.

June 2024

In June, TC Energy sells PRGT to the Nisga’a treaty government and Texas-based Western LNG, a new company. The new owners propose a new terminal on Pearse Island, far from Prince Rupert.

August 21, 2024

Gitanyow hereditary chiefs and Indigenous youth establish a road checkpoint on their Lax’Yip, stopping PRGT traffic across their territories. The Ganeda (Frog clan) Wilps Watakhayetsxw and Gamlakyeltxw vow that they will not allow the destruction of these lands – this area was identified in the original project review as an extremely valuable site for fish, wildlife and cultural uses. The checkpoint resists the destruction of their traditional and ancestral territories by turning away PRGT construction vehicles, while educating other visitors about their lands as they pass through.

August 24, 2024

In August, PRGT starts logging along the pipeline route on Nisga’a treaty lands (the only place they had permits to work). They clear two per cent of the right-of-way.

At an average width of 25 metres, they clear only half the corridor needed for pipeline construction. They did no grading, dug no trenches and laid no pipe.

They skip over any terrain that could be expensive or challenging: stream crossings and wetlands, steep slopes, rock bluffs and of course the seafloor portion of the route.

They also steer clear of neighbouring Gitanyow and Gitxsan territory, where many house groups oppose the pipeline.

August 27, 2024

Nisga’a member blocks a road leading to a work camp in Nisga’a territory. Their group, the Nass Valley Tribal Alliance Society, launches a local petition with over 200 signatures to explore an injunction against the construction of PRGT.

August 29, 2024

Frontline communities launch legal challenge against the B.C. energy regulator for bending rules and bypassing legal steps to greenlight PRGT’s “substantial start” construction.

October 2024

Opposition expands, as house groups begin establishing permanent cabins and a dog sanctuary on the territories.

October 2024

Simogit Gamlakyeltxw (Wil Marsden), a Gitanyow Hereditary Chief, runs as a Green party candidate in the recent BC election – the only party to oppose the PRGT in their platform.

October 24, 2024

Legal Challenge to Ksi Lisims LNG project

PRGT cannot legally begin construction on over 90 per cent of its route, until the proposed Ksi Lisims LNG project has received a positive final investment decision. Ksi Lisims has not yet received its environmental certificate from the B.C. Environmental Assessment Office and is also opposed by the Lax Kw’alaams First Nation and the Gitanyow Hereditary Chiefs.

Late November 2024

Project proponents file for a “substantially started determination” for the project, in an attempt to avoid a new environmental assessment.

November 25, 2024

First issued in 2014, PRGT environmental certificate expires, alongside all agreements with First Nations.

If the proponents are granted the substantially started determination, the certificate will be extended indefinitely. If not, the project will have to go through a new environmental assessment process under modern environmental laws before proceeding.

The Environmental Assessment Office is putting together a “decision package” for the minister on whether to grant PRGT a permanent certificate, which would open the door to full-scale pipeline construction next year.

November 25, 2024

Gitanyow Hereditary Chiefs issue press release on plan for Indigenous Protected Conservation Area to prevent pipeline resurrection and send message to potential financiers and investors.

March 2025

Will the new Environment Minister, Tamara Davidson, respect Indigenous rights and demands to put PRGT through a modern environmental assessment? Stay tuned for updates.

Take
Action

Pressure the new Environment Minister, Tamara Davidson and the new cabinet to stop PRGT.

Take your action beyond the screen – talk to your friends and local organizations about standing in solidarity with frontline land defenders against PRGT. Solidarity groups in Victoria, Vancouver and Squamish have organized rallies, banner drops, street theatre, bake sales and benefit concerts, with more actions to come!

By signing the petition, you are showing your solidarity with the youth who are opposing the PRGT pipeline and advocating for responsible leadership, environmental protection and cultural resurgence.

Show your support to Teresa Brown’s Land defence and Dog Sanctuary, located on the PRGT pipeline right-of-way on Gitxsan Laxyip.

With winter settling in, Teresa needs funds and supplies to keep her and the pups warm all winter.To support, send donations via e-transfer/paypal to landbackcc@gmail.com

You can also support Teresa’s dog sanctuary and cabin build by buying Gitxsan land defense fundraiser t-shirts and hoodies
